Infrastructure

The Buildout

Satellite imagery reveals how AI data centers are reshaping the American landscape — from factory floors to server halls, farmland to construction sites — in months, not years.

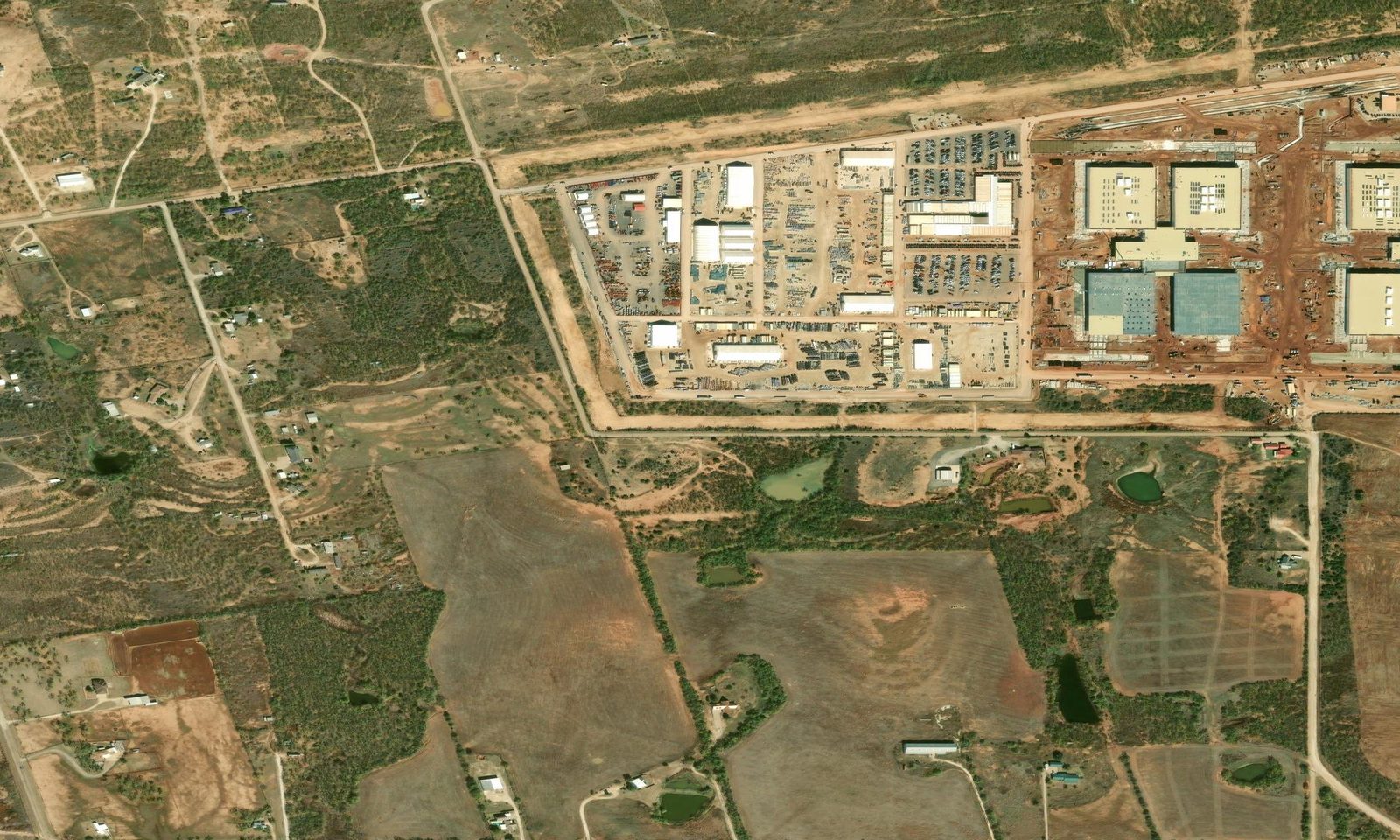

Abilene, Texas. Two years ago this was open farmland on the edge of a drought-prone city. Today it's an active construction site for Stargate — a $500 billion AI campus that, when complete, will consume more electricity than Pittsburgh and nearly four million gallons of water every day. Drag the slider. Across the country, the same transformation is rewriting the American landscape in months, not years.

Stargate's planned Abilene campus will draw ~500 megawatts of power and an estimated ~4.8M gallons of water per day — in one of Texas's most drought-prone regions.

How much power is that?

Megawatt numbers are easy to gloss over. Here's how the largest AI data centers compare to familiar references.

Average US home
0.0012 MW
Walmart Supercenter
1.5 MW
Large hospital
~5 MW
Pittsburgh, PA (peak load)
~400 MW
xAI Colossus (Memphis)
425 MW
Stargate (Abilene)
590 MW
Typical nuclear reactor
~1,000 MW
Anthropic/Amazon (New Carlisle)
1,092 MW
Hoover Dam (capacity)
2,080 MW

MW = megawatts of continuous power draw. A single large AI training campus now rivals an entire mid-sized American city — or a nuclear reactor — in electricity demand.

$500B
Announced Investment
500 MW
Planned Power Draw
4.8M gal
Est. Water Use / Day
≈ 16,000 homes
ABILENE, TEXAS — OPEN FARMLAND → STARGATE AI CAMPUS
Satellite view — 2023
Satellite view — 2025
2023 2025 BEFORE AFTER
POWER SOURCE — Texas grid 500 MW planned draw
28% Renewables8% Nuclear50% Natural Gas12% Coal2% Other

Open farmland on the outskirts of Abilene, announced as the site of the largest AI infrastructure project in history. At full capacity, this single campus would draw more electricity than Pittsburgh.

200 MW
Power Draw
2.3M sq ft
Facility Size
1.9M gal
Est. Water Use / Day
≈ 6,300 homes

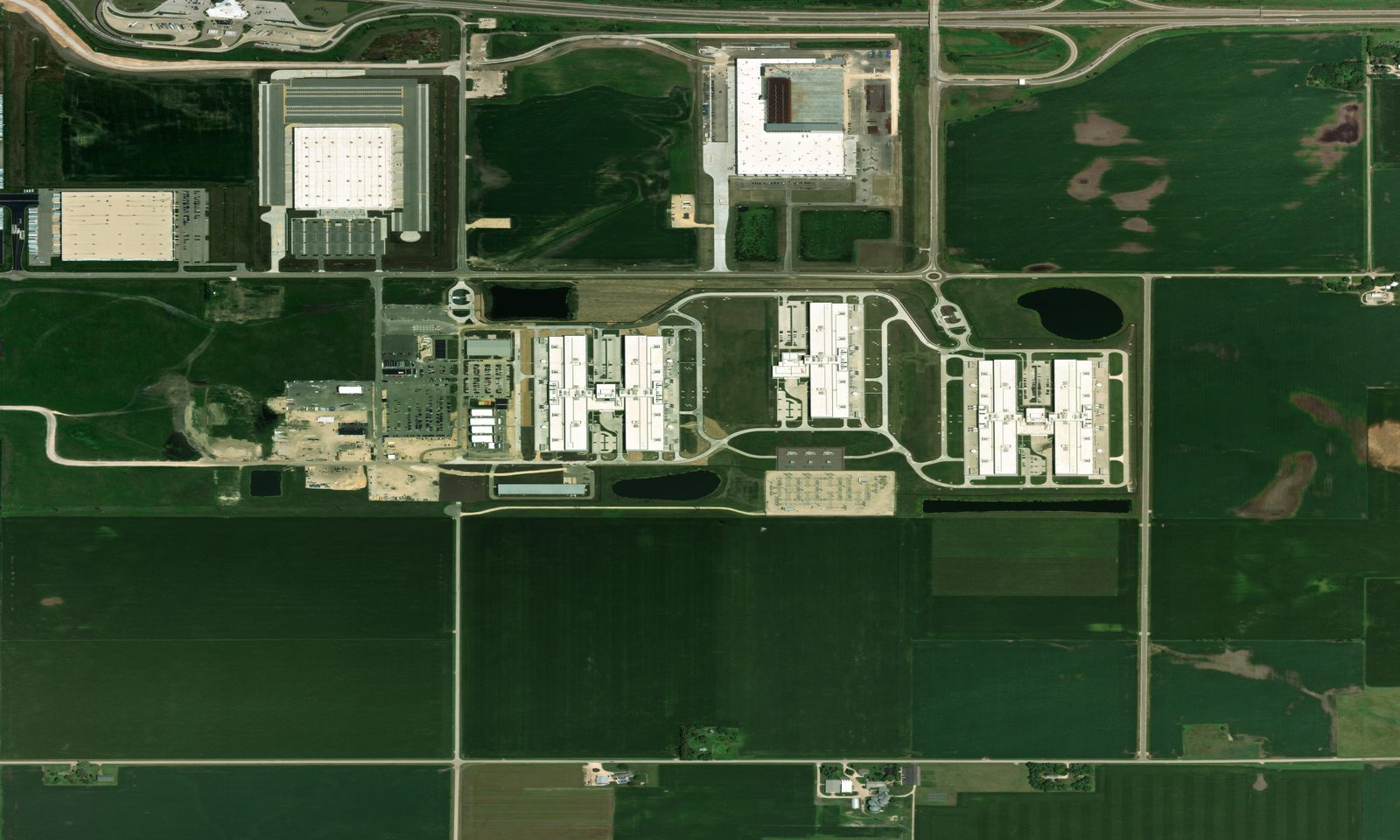

DEKALB, ILLINOIS — FARMLAND → META AI DATA CENTER
Satellite view — 2020
Satellite view — 2025
2020 2025 BEFORE AFTER
POWER SOURCE — Illinois grid 200 MW draw
15% Renewables52% Nuclear12% Natural Gas19% Coal2% Other

505 acres of Illinois farmland became one of Meta’s largest data centers — a 2.3 million square foot facility completed in 2024, with a 560-acre expansion already proposed next door.

$1.8B
Investment
150 MW
Power Draw
1.4M gal
Est. Water Use / Day
≈ 4,700 homes

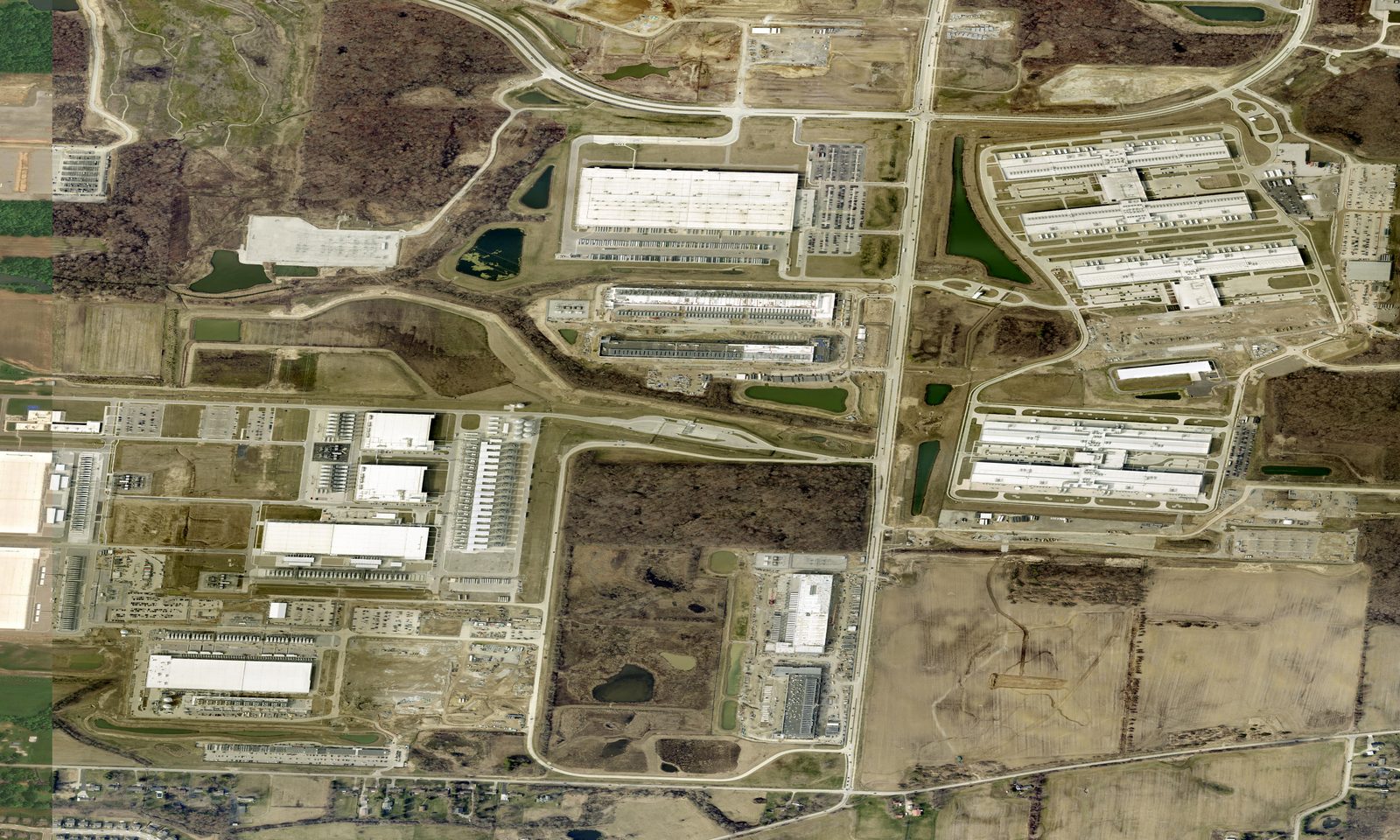

NEW ALBANY, OHIO — FARMLAND → GOOGLE DATA CENTER CAMPUS
Satellite view — 2019
Satellite view — 2024
2019 2024 BEFORE AFTER
POWER SOURCE — Ohio grid 150 MW draw
5% Renewables10% Nuclear55% Natural Gas28% Coal2% Other

Ohio farmland northeast of Columbus transformed into one of Google’s expanding data center campuses — part of a wave that has made New Albany a major hub for cloud infrastructure.

$1.2B
Investment
120 MW
Power Draw
1.1M gal
Est. Water Use / Day
≈ 3,700 homes

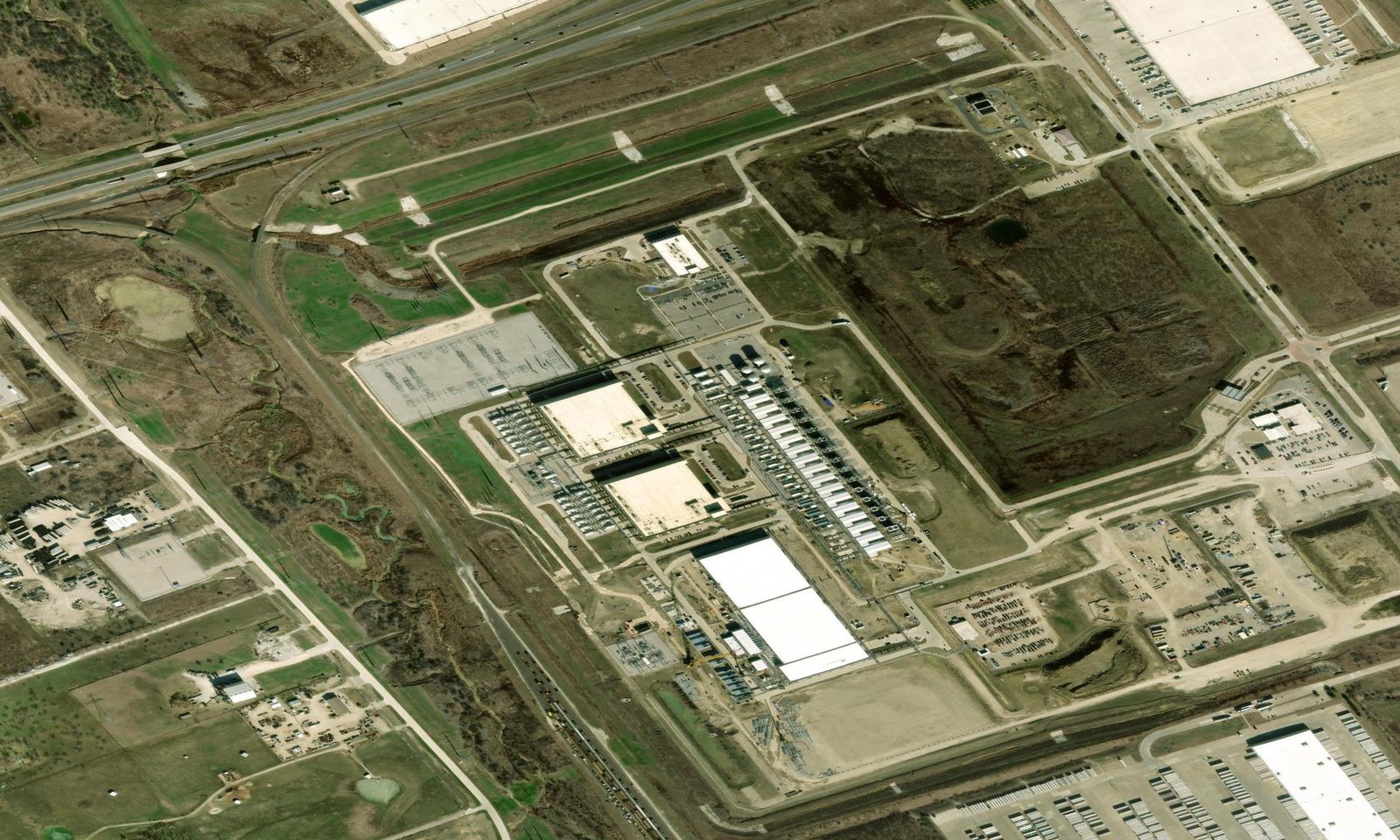

MIDLOTHIAN, TEXAS — OPEN LAND → GOOGLE AI DATA CENTER
Satellite view — 2019
Satellite view — 2024
2019 2024 BEFORE AFTER
POWER SOURCE — Texas grid 120 MW draw
28% Renewables8% Nuclear50% Natural Gas12% Coal2% Other

South of Dallas, Google built a major data center campus on previously undeveloped land — part of the company’s multi-billion dollar expansion across Texas.

Power Consumption

Estimated electrical draw by featured site, in megawatts

Sources: Epoch AI facility database, operator filings, EIA interconnection records. 1 MW \u2248 800 homes.

Built in a Hurry

Gigawatt-scale AI data centers are being built in months, not years — an order of magnitude faster than the infrastructure we historically built to power them.

xAI Colossus (in red) went from shuttered appliance factory to 100,000-GPU supercomputer in 122 days. A nuclear reactor of comparable output takes a decade or more. The grid wasn't designed for this pace.

Land Value Transformation

Assessed property value before acquisition vs. current estimated value

Sources: County assessor records, SEC filings, public land records. Values are estimated based on available data.

Who Pays

Behind every AI data center is a package of public subsidies — property tax abatements, infrastructure grants, payment-in-lieu-of-tax deals — negotiated with state and local governments eager for the headline investment figures.

Tax abatements (PILOT, property, Chapter agreements)
Grants & infrastructure support

Figures in USD millions, based on publicly reported agreements and available at time of announcement. Actual values vary with assessed property values, employment thresholds, and inflation adjustments. Sources: state EDC filings, Good Jobs First Subsidy Tracker, local news reporting. Values are approximate and should be verified from primary sources before publication.

The National Footprint

AI data center facilities across the United States — shape by operator, color by power draw

Interactive map

Set window.__MAPBOX_TOKEN or add a <meta name="mapbox-token"> tag to activate.

Operator
Google
Meta
Microsoft
Amazon
OpenAI / Oracle
xAI
Power (MW)
02505007501000

Size scales with power draw. Sites featured in the story above have a white halo and label.
